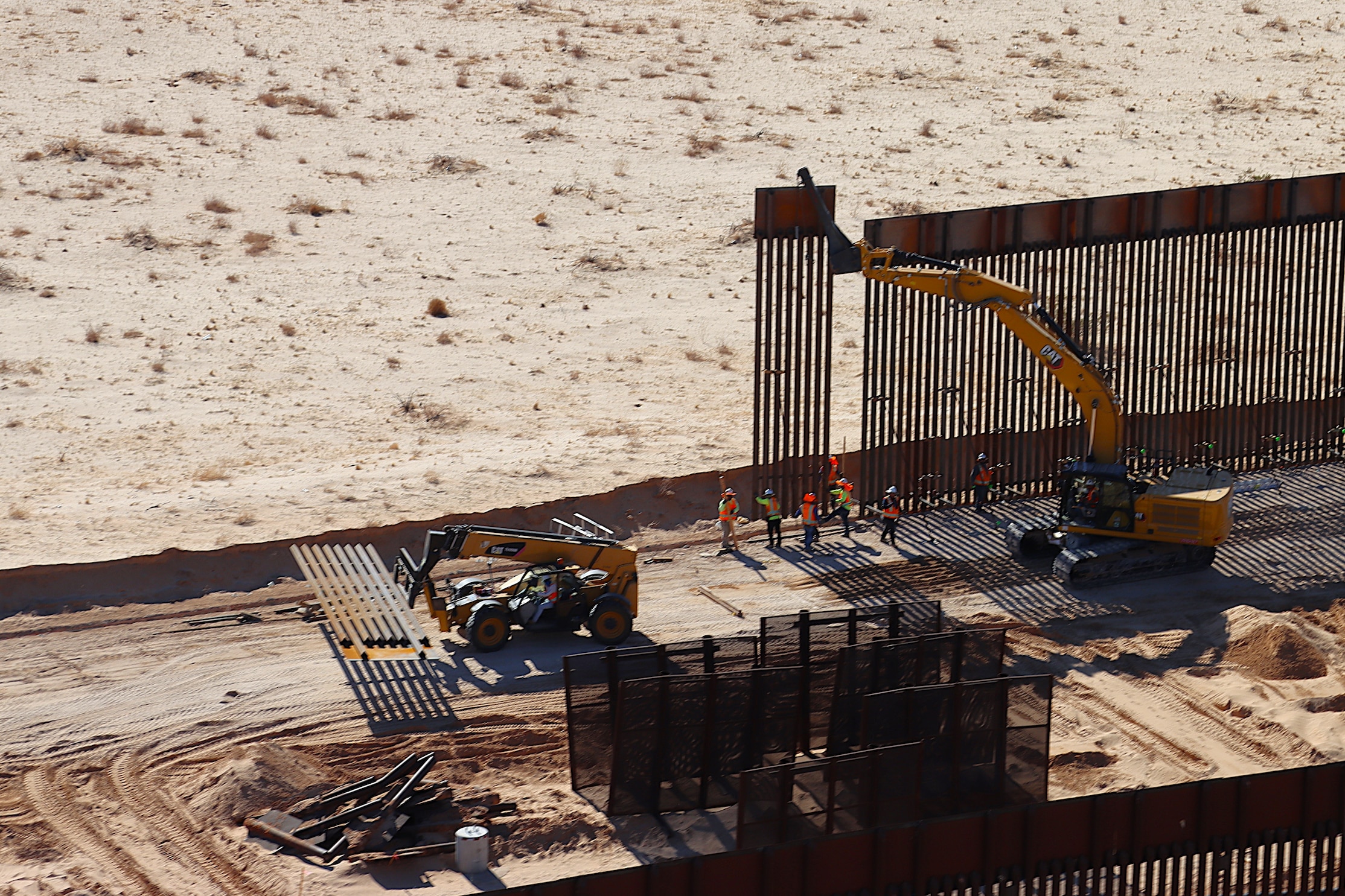

U.S. Army Corps of Engineers South Pacific Border Task Force install border barrier panels at the BMGR-1 project site near Yuma, Arizona, Nov. 17. USACE is replacing permanent border barriers along the southern border of the U.S. at the direction of the U.S. Army by the Secretary of War, in response to the presidential national emergency declaration dated Jan. 20, 2025, authorizing the use of Section 2803 of Title 10, U.S. Code.
Border Task Force

U.S. Army Corps of Engineers South Pacific Border Task Force install border barrier panels at the BMGR-1 project site near Yuma, Arizona, Nov. 17.

Border Task Force

Background and Scope of BMGR-1 and NDA-1 Projects

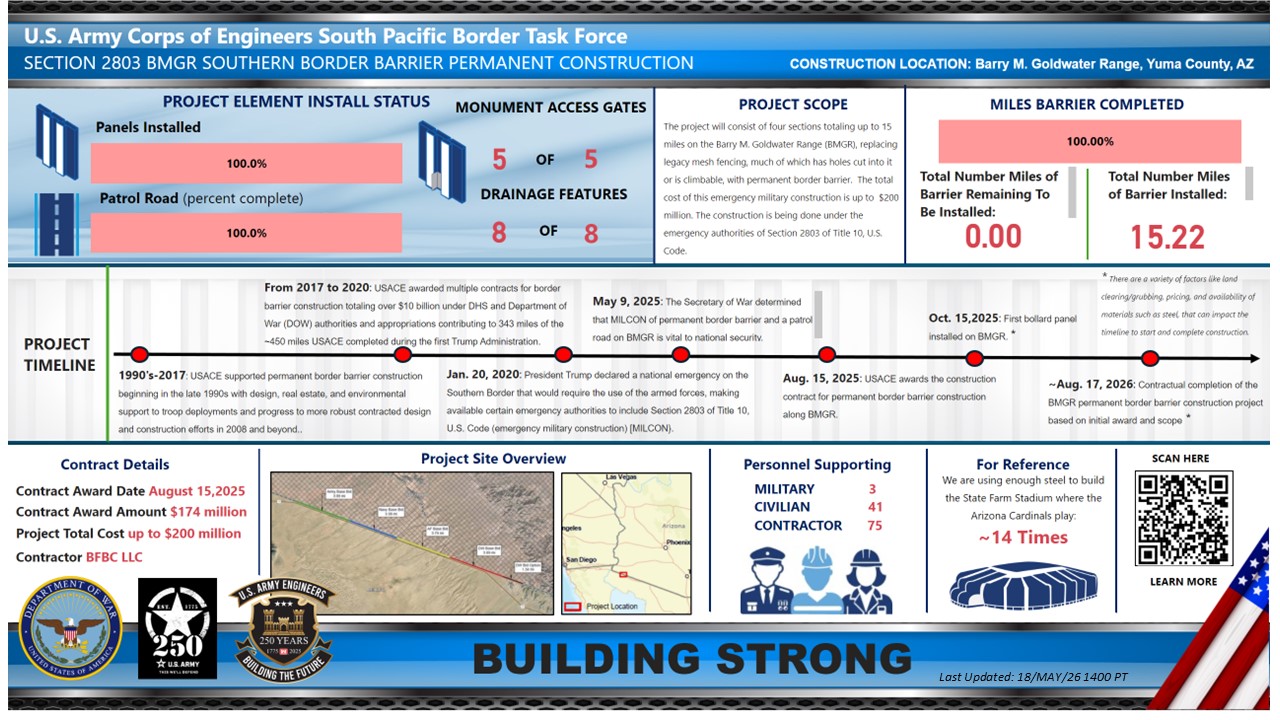

The BMGR-1 project consists of four sections totaling approximately 15 miles in the Barry M. Goldwater Range, replacing legacy mesh fencing, much of which has holes cut into it or is climbable, with permanent border barrier. The total cost of this emergency military construction is approximately $200 million.

USACE is leading the construction, including the planning and design, of permanent border barrier in the Barry M. Goldwater Range. We awarded the construction contract on August 15, 2025. Construction began on October 15, 2025.

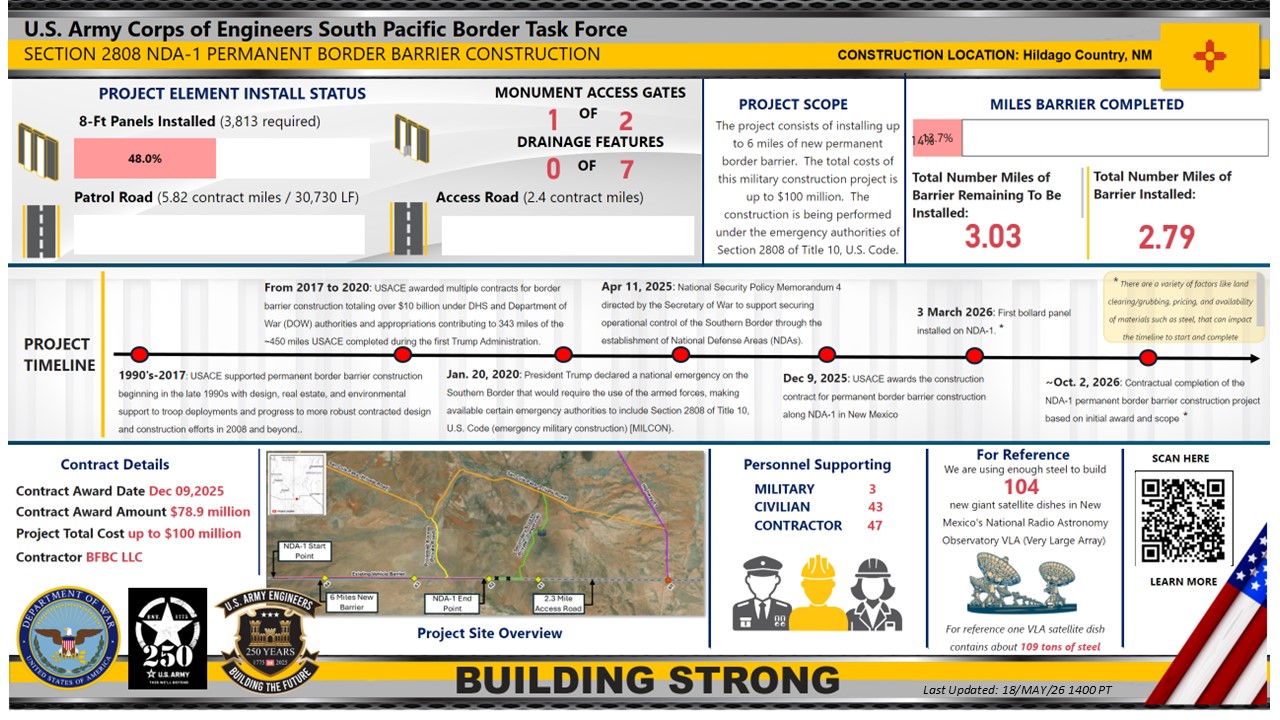

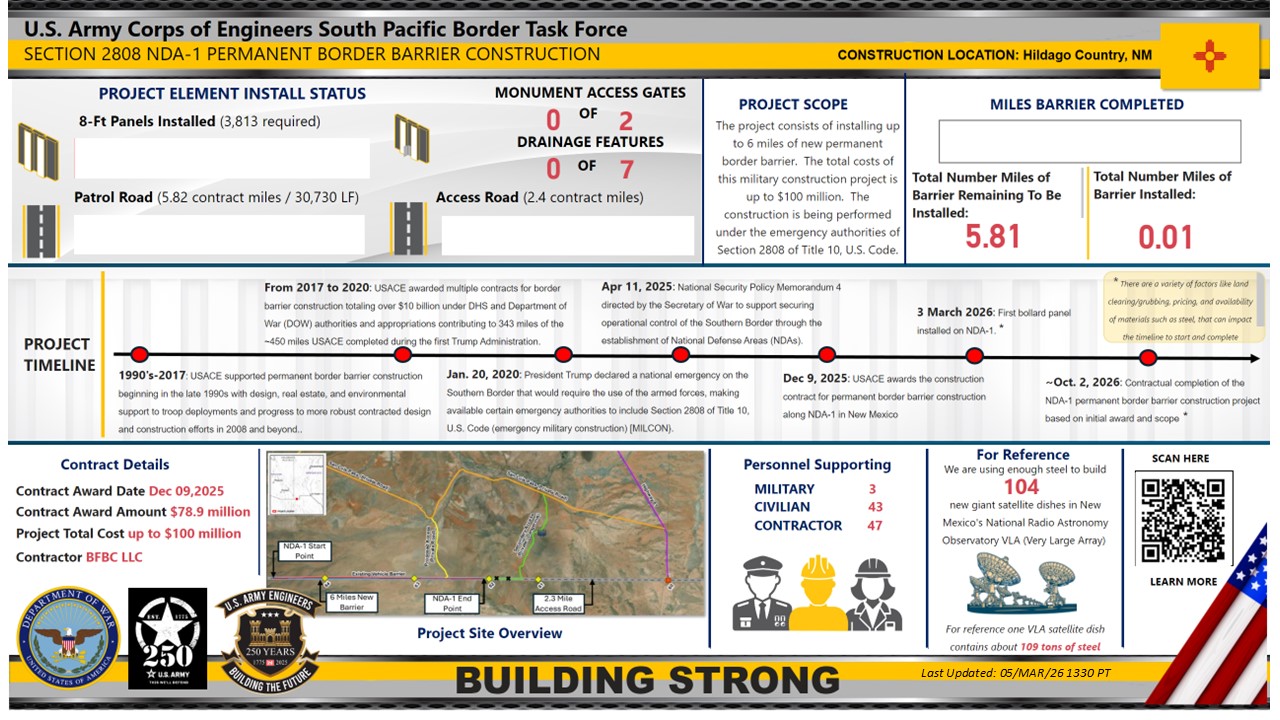

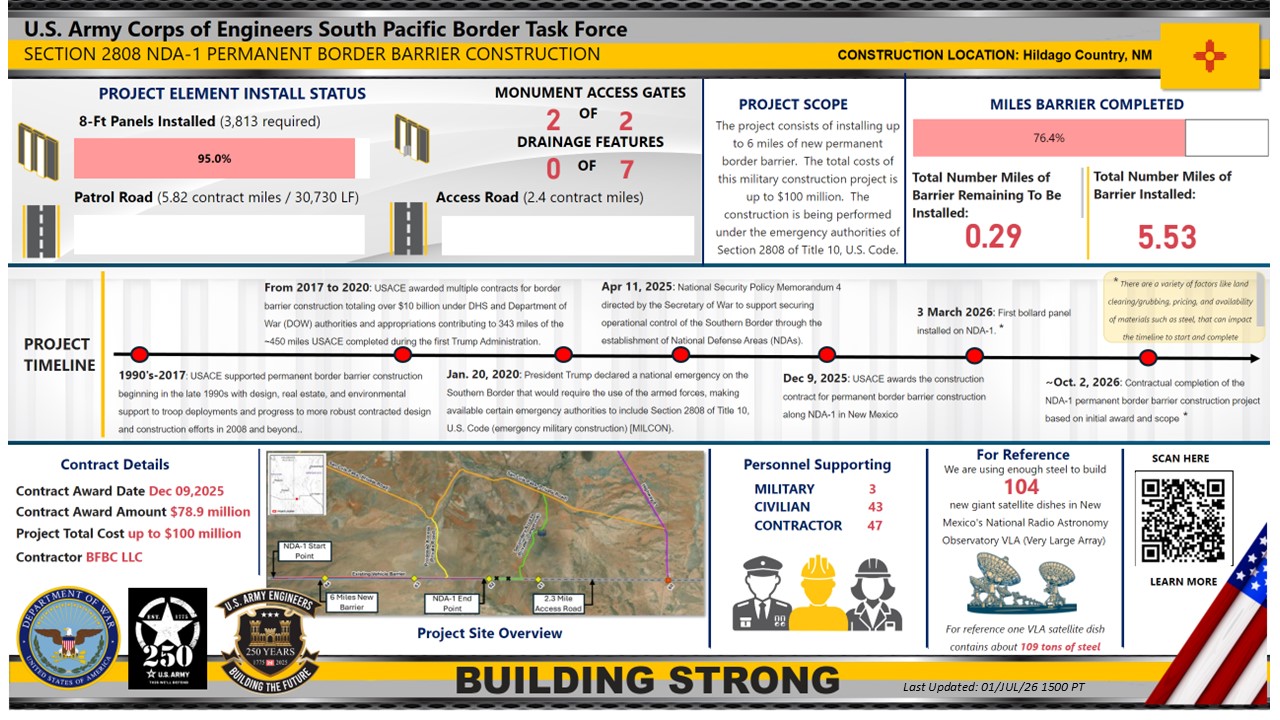

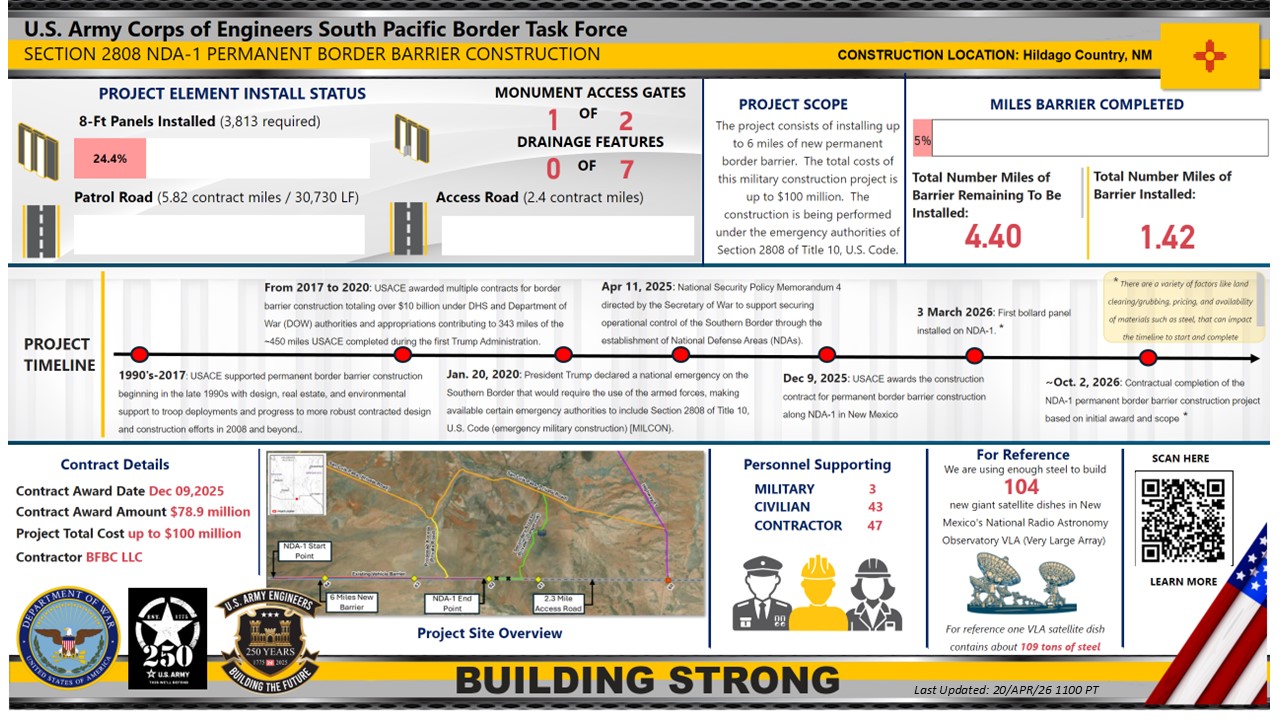

The National Defense Area -1 project consists of installation of up to six miles of new permanent border barrier with access gates, patrol roadways and access improvements through the Roosevelt Reservation Corridor in Hildago County, New Mexico. USACE awarded the military construction contract to BFBC, LLC, a subsidiary of Barnard Construction, for $78.9 million Dec. 9, 2025.

USACE is leading the planning, design and construction of permanent border barrier in the national defense areas, under the emergency authorities of Section 2808 of Title 10, U.S. Code.
